Concrete Removal Calculator
Concrete Removal Calculator Cost Guide
A Concrete Removal Calculator helps homeowners estimate the potential cost of breaking, cutting, hauling, and disposing of concrete during a remodeling or demolition project.
Concrete removal can involve patios, driveways, sidewalks, slabs, foundations, footings, and structural concrete, with costs changing significantly according to reinforcement, thickness, accessibility, labour difficulty, and disposal requirements.
This cost calculator provides a practical preliminary price estimate for projects in both the USA and UK. Users can enter the concrete area in square feet or square meters and compare material types, project scopes, existing conditions, equipment setup, labour difficulty, and optional services.
The estimate separates material cost, labour cost, site setup or installation expenses, additional services, and removal costs to make early project budgeting easier.
Concrete Removal Calculator
Estimate concrete demolition, breaking, hauling, and disposal costs for remodeling projects in the USA and UK.
Free Concrete Removal Calculator
Material / Project Types
Concrete removal difficulty depends heavily on the type of concrete and how it was originally constructed.
Plain concrete is generally easier to break apart than reinforced material because it does not contain a substantial network of steel reinforcement. It is commonly found in smaller patios, pathways, and some residential slabs.
Reinforced concrete contains steel rebar or reinforcing mesh, which usually increases demolition time. Contractors may need breakers, saws, cutting tools, and additional labour to separate concrete from reinforcement before disposal.
Stamped or decorative concrete can also require substantial demolition work, particularly when thick slabs, bonded overlays, or reinforced bases are present.
Heavy structural concrete is typically the most expensive category. Foundations, footings, structural slabs, and other thick concrete sections may require hydraulic breakers, excavators, concrete saws, or other specialized equipment.
Project type also matters. Patio and walkway removal is usually less demanding than driveway removal, while foundation and structural concrete demolition can involve heavier equipment and more difficult access.
Main Factors Affecting Cost
Concrete area is one of the primary factors affecting a Concrete Removal Calculator estimate. Larger areas require more breaking, loading, hauling, and disposal capacity.
Concrete reinforcement is another major consideration. Rebar and reinforcing mesh can increase labour cost because steel must often be cut or separated from broken concrete.
Thickness is also important, even when two projects have the same surface area. A thick structural slab contains substantially more concrete than a thin patio slab and may therefore require greater equipment capacity and more disposal volume.
Project condition can influence replacement cost and repair cost planning. Straightforward replacement projects may allow complete removal, while selective repair demolition may require precise saw cutting and careful removal around concrete that will remain.
Access also affects pricing. Concrete that can be reached by machinery is often easier to remove than slabs inside restricted courtyards, basements, or areas where all debris must be moved manually.
Labour difficulty, disposal distance, tipping fees, reinforcement, underground services, and the availability of heavy equipment can all change the final price estimate.
Cost Breakdown
The calculator divides the estimated concrete removal expense into five main categories.
Materials represents demolition consumables and the cost impact associated with the selected concrete type. Reinforced and heavy structural concrete generally create higher material-related demolition expenses.
Labour estimates the workforce required to cut, break, separate, load, and prepare concrete for disposal. Complex demolition, reinforcement, limited access, and difficult conditions increase the estimated labour cost.
Installation represents temporary equipment and site setup rather than permanent construction. The installation cost category can include site protection, equipment positioning, cutting preparation, and heavy demolition setup.
Additional expenses can include rebar cutting, concrete saw cutting, heavy equipment, additional hauling, basic grading after removal, and enhanced dust-control measures.
Removal covers loading, transportation, and disposal of demolished concrete. Reinforced or heavy structural concrete typically costs more to handle than light residential slabs. If removal is not required, the calculator still displays this category with a zero value.
Why Use This Calculator?
The Concrete Removal Calculator gives homeowners a practical way to estimate demolition costs before requesting contractor bids or planning replacement work.
Users researching USA cost receive results in US dollars using USA-oriented pricing assumptions. Homeowners researching UK cost receive estimates in pounds sterling using UK-oriented assumptions. Country selection changes pricing and currency without changing the selected measurement unit.
The calculator makes it easy to compare a simple patio removal project with a reinforced driveway, foundation, or structural concrete demolition. It can also show how rebar, saw cutting, heavy equipment, difficult access, additional hauling, and grading affect the final price estimate.
This can be particularly useful when planning a broader project where demolition will be followed by new concrete work, landscaping, drainage improvements, foundation repairs, or other construction with its own replacement cost, repair cost, and installation cost.
Concrete Removal Calculator: Cost, Weight & Disposal Guide
A Concrete Removal Calculator estimates the likely cost of breaking, loading, hauling, and disposing of an existing slab. The result can change substantially with slab size and thickness, reinforcement, access, demolition difficulty, and disposal requirements.
Two concrete slabs can cover exactly the same area yet produce very different removal budgets. A 400 sq ft patio that is 4 inches thick contains only two-thirds as much concrete as a 400 sq ft slab that is 6 inches thick, before rebar, machine access, hauling, or disposal are considered.
That is why the most useful way to read a Concrete Removal Calculator result is not as a single price per square foot. Area tells you how much ground the concrete covers; thickness turns that area into volume, and volume helps explain debris weight, equipment demand, loading time, and disposal requirements.
Concrete Removal Calculator at a Glance
- Estimate, not a bid: Use the calculated range for early budgeting and contractor comparison rather than treating it as a guaranteed final price.
- Thickness changes quantity: Increasing a slab from 4 inches to 6 inches increases concrete volume by about 50% when surface area stays the same.
- Reinforcement changes the work: Rebar or wire mesh can add cutting and separation work even when the slab dimensions stay unchanged.
- Debris weight matters: Concrete is heavy enough that a dumpster, truck, or UK skip may reach a weight restriction before it looks full.
- Small jobs behave differently: Mobilization, equipment delivery, and minimum disposal charges can make a small slab expensive on a per-square-foot basis.
- US and UK estimates are separate: Local labor markets, disposal systems, taxes, terminology, and pricing practices differ, so UK figures should not be created by converting a US dollar estimate into pounds.

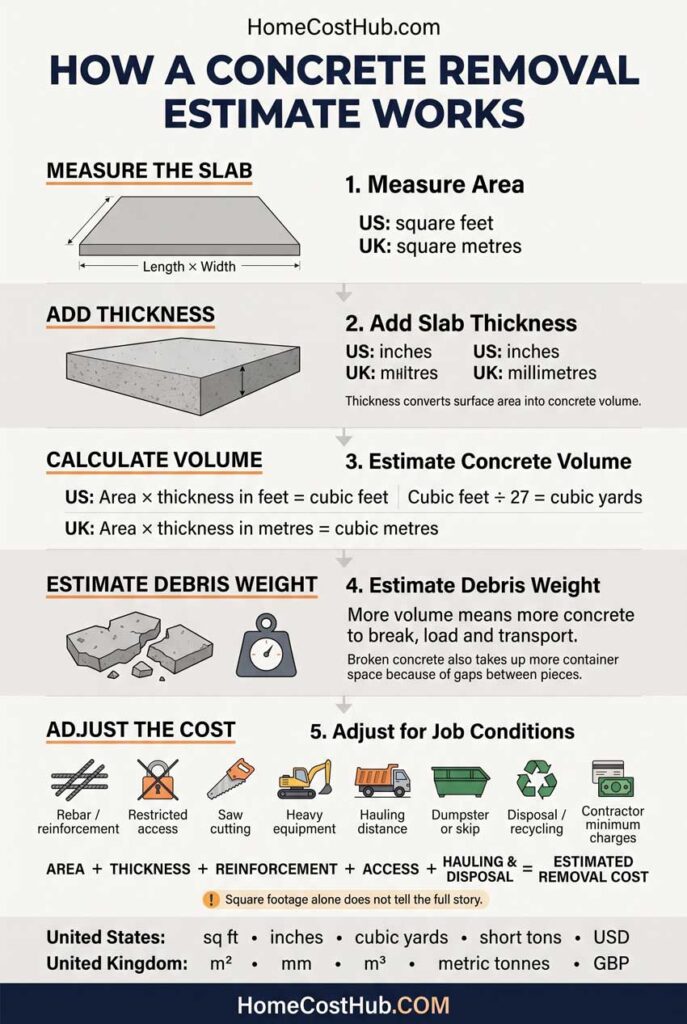

How to Read Your Concrete Removal Calculator Result
A useful Concrete Removal Calculator result should be read as a planning range rather than a promise that every contractor will quote the midpoint. The lower end normally represents a relatively straightforward version of the selected project, while the upper end provides room for more demanding site conditions or services.
Start with the total estimated range, then compare it with the amount of concrete involved. In the United States, that often means checking the effective cost per sq ft. In the United Kingdom, compare the result per m². A per-unit figure makes quotes easier to compare, but only when the contractors are pricing the same scope.
Next, look at volume and estimated debris weight. These figures explain why a project that appears modest from above can still require substantial hauling. A 400 sq ft patio at 4 inches thick contains about 133 cubic feet, or roughly 4.94 cubic yards, of solid concrete. Increasing the same slab to 6 inches creates about 200 cubic feet, or 7.41 cubic yards—roughly 50% more material.
That difference affects more than disposal. More concrete must be broken, handled, loaded, transported, and processed. If reinforcement or difficult access is also present, the relationship between extra volume and final cost may not be perfectly linear.
The Concrete Removal Calculator is therefore most useful as the first budget checkpoint. A site inspection and written contractor scope remain necessary when precise pricing is required.
The Math Behind a Concrete Removal Estimate

Concrete demolition becomes easier to understand when the project is treated as a chain rather than a price-per-area problem:
Area → thickness → volume → approximate weight → removal effort → hauling and disposal demand.
US Calculation
Area: Length × Width = square feet
Volume: Area × thickness in feet = cubic feet
Cubic yards: Cubic feet ÷ 27 = cubic yards
For a 20 ft × 20 ft patio:
- 20 × 20 = 400 sq ft
- 4 inches = 0.333 ft
- 400 × 0.333 ≈ 133.3 cubic feet
- 133.3 ÷ 27 ≈ 4.94 cubic yards
For preliminary weight calculations, normal concrete is often approximated at about 150 lb per cubic foot. American Concrete Institute educational material demonstrates roughly that density for normal concrete. Actual mixes can vary, so the Concrete Removal Calculator should be interpreted as an estimate rather than a scale ticket.
Using that planning assumption, 133.3 cubic feet would weigh roughly 20,000 lb, or about 10 US short tons.
UK Calculation
Area: Length × Width = m²
Volume: Area × thickness in metres = m³
For weight planning, multiply volume by an appropriate concrete density assumption and show that assumption alongside the result.
A 5 m × 4 m concrete pad covers 20 m². At 100 mm thick, or 0.1 m, its solid volume is:
20 m² × 0.1 m = 2 m³.
Using an approximate normal-concrete density equivalent to about 2,400 kg/m³ gives roughly 4,800 kg, or 4.8 metric tonnes. The real weight can differ with concrete composition, reinforcement, moisture, and other conditions.
There is another practical distinction: solid concrete volume is not the same as loose broken-debris volume. Once demolished, irregular chunks leave air gaps between pieces. That matters when selecting a container even though the concrete’s mass has not disappeared.

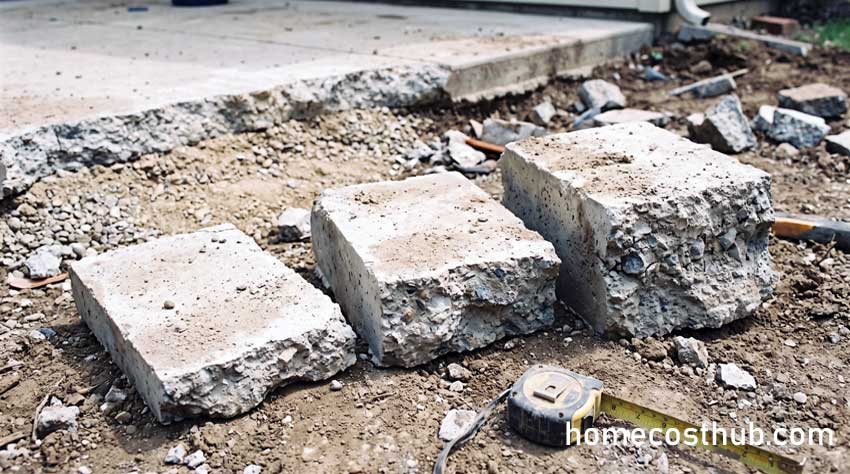

How Slab Thickness Changes the Removal Job

Thickness is one of the easiest inputs to underestimate because most of the slab is hidden. The table below uses the same 500 sq ft surface area to show how quickly material quantity changes.
| Thickness | Approx. Solid Volume | Approx. Quantity vs. 4 in. | Typical Removal Implication |
|---|---|---|---|
| 4 in. | 166.7 ft³ / 6.17 yd³ | Baseline | Common residential-scale quantity, though reinforcement and access still matter |
| 6 in. | 250 ft³ / 9.26 yd³ | About 50% more | More breaking, handling, and hauling than the same-area 4-in. slab |
| 8 in. | 333.3 ft³ / 12.35 yd³ | About 100% more | Twice the solid concrete volume of the 4-in. example |
Doubling thickness approximately doubles solid concrete volume when area remains unchanged. That mathematical relationship is simple; the effect on price is less predictable. Equipment mobilization, reinforcement, saw cutting, access, contractor minimums, and disposal arrangements can prevent the final bill from scaling at exactly the same rate.
If an exposed slab edge is available, measuring it can improve a Concrete Removal Calculator estimate considerably. Older driveways may also contain thickened edges or localized sections that are deeper than the visible slab suggests.
Estimating Concrete Debris Weight Before Demolition

Debris weight deserves its own calculation because disposal can become a logistical constraint long before a concrete pile looks unusually large.
Using roughly 150 lb/ft³ as a planning density for normal concrete, a 400 sq ft slab at 4 inches thick works out to about 20,000 lb, or approximately 10 US short tons. That is far more than the payload of many ordinary homeowner vehicles and can exceed the permitted load of some rental containers.
For a UK example, a 20 m² slab at 100 mm thick contains about 2 m³ of solid concrete. At roughly 2,400 kg/m³, that is approximately 4.8 metric tonnes before allowing for reinforcement or other attached material.
Container capacity must be checked with the actual provider. Dumpster and skip companies can impose both volume and weight limits, and those limits vary by container type, material, location, and transport rules. A container filled only partway with dense concrete may already have reached its allowed weight.
This is also why a Concrete Removal Calculator should not equate “cubic yards of slab” with “cubic yards of dumpster space” as if demolished concrete packed perfectly. Broken pieces create voids, and debris size affects how efficiently a load can be transported.
Concrete Removal Cost Benchmarks for the US and UK
Published cost guides are useful for checking whether a Concrete Removal Calculator result sits in a plausible market range, but they are not official national rates.
| Region | Published Benchmark | Useful For | Important Limitation |
|---|---|---|---|
| United States | Angi cites about $2–$6 per sq ft for old concrete patio removal including demolition and disposal | Early residential budgeting | Actual pricing changes with location and project conditions |
| United Kingdom | MyBuilder cites roughly £50–£150 per m² for concrete removal | Broad UK comparison | Size, thickness, disposal requirements, and scope can move pricing outside the range |
Angi’s 2026 patio cost guidance currently lists roughly $2–$6 per sq ft for old concrete removal, including demolition and disposal. MyBuilder’s January 2026 UK guide places typical concrete removal at approximately £50–£150 per m², depending on size, thickness, and disposal requirements.
These numbers are best treated as external reference points, not inputs that override the details of your job. Structural demolition, heavy reinforcement, restricted access, unusual disposal requirements, or very small projects can fall outside broad consumer-guide ranges.
Why a Small Concrete Job Can Cost More per Square Foot
A 50 sq ft slab does not necessarily cost one-tenth as much to remove as a 500 sq ft slab. Some expenses are attached to starting the job rather than to every additional square foot.
A contractor may still need to schedule a crew, load and transport tools, deliver equipment, set up saws, arrange a dumpster or hauling vehicle, travel to the site, and clean the work area. Disposal facilities may also have minimum charges.
Imagine two unreinforced slabs with equally good access. The larger project spreads mobilization across hundreds of square feet. On the smaller job, many of those setup tasks still exist, so the effective cost per sq ft can look disproportionately high.
This is a useful warning when checking a Concrete Removal Calculator against a contractor bid: a higher unit price does not automatically mean the contractor has priced the job incorrectly.
DIY vs Professional Concrete Removal
| Approach | Best Suited For | Main Equipment | Physical Demand | Disposal Responsibility | Main Limitation |
|---|---|---|---|---|---|
| Manual DIY | Small, manageable slabs | Hand tools appropriate to the work | Very high | Homeowner | Slow and impractical for substantial concrete |
| Rented breaker | Small-to-medium accessible slabs | Electric or pneumatic breaker plus supporting tools | High | Homeowner | Breaking the slab does not solve loading or disposal |
| Mini excavator / skid steer | Larger accessible areas | Machine with appropriate attachment | Lower manual breaking demand | Still requires a hauling plan | Needs suitable access, skill, and safe working space |
| Professional contractor | Reinforced, thick, large, structural, or difficult-access work | Selected for site conditions | Handled by contractor crew | Can be included in scope | Higher cash outlay than suitable DIY work |
DIY savings can look attractive because labor is removed from the contractor’s invoice. The difficult part is that demolition is only one stage. Several tons of fragments still have to be moved, loaded, transported, and accepted by an appropriate facility.
Rebar, concealed services, saw cutting, dust, vibration, limited machine access, and heavy pieces can quickly change the risk profile. A Concrete Removal Calculator may help compare budgets, but it should not be used as evidence that a technically difficult slab is suitable for DIY removal.
Pros and Cons of DIY Concrete Removal
Pros
- Potential labor savings: Small, straightforward projects may cost less when the homeowner can safely handle the work and disposal.
- Schedule control: The project can be broken into manageable sessions rather than booked around a contractor’s availability.
- Useful for limited demolition: A small accessible pad can be very different from a reinforced driveway or structural slab.
Cons
- Heavy physical work: Breaking concrete is only the beginning; every piece must still be handled.
- Rental costs accumulate: Tool, machine, trailer, dumpster, skip, or transport costs can narrow the expected savings.
- Reinforcement slows progress: Wire mesh and rebar can keep broken sections tied together.
- Debris is easy to underestimate: A modest slab can weigh several tons.
- Damage and safety risks remain: Underground utilities, nearby structures, dust, vibration, and equipment operation require careful planning.
Should You Remove the Concrete or Repair It?
Cracking alone does not automatically mean the whole slab should be demolished. The right decision depends on what failed and what the area needs to do next.
Full removal may make more sense where the concrete has extensive breakup, major displacement, severe deterioration, exposed or deteriorated reinforcement, drainage problems that require rebuilding the base, or a planned layout change that makes the existing slab unusable.
Repair deserves consideration when the slab remains broadly serviceable and the problem is limited to surface deterioration, localized cracking, minor settlement, or cosmetic wear. Resurfacing, localized repair, or leveling may preserve more of the existing concrete.
If movement or cracking suggests a structural problem, obtain an appropriate professional assessment before choosing removal based solely on the lowest Concrete Removal Calculator result.
The same principle applies to larger renovation planning. Demolition-heavy work may be one small piece of a broader Kitchen Remodeling budget, while a lower-disruption update can sometimes be evaluated separately with tools such as the Cabinet Painting Cost Calculator.
Concrete Removal Decision Tree
1. Is the slab generally structurally sound?
- Yes: If damage is mainly cosmetic or localized, assess repair, resurfacing, or leveling before planning full removal.
- No or unsure: Continue to Step 2.
2. Is the slab severely displaced, deteriorated, or being removed for a new layout?
- Yes: Full removal may be appropriate.
- No: A professional condition assessment may prevent unnecessary demolition.
3. Is the concrete small, relatively thin, accessible, and apparently unreinforced?
- Yes: Compare realistic DIY tool, transport, and disposal costs with the contractor’s minimum charge.
- No: Professional demolition is usually more practical.
4. Is rebar, structural concrete, restricted access, or underground infrastructure involved?
- Yes: Seek professional assessment before destructive work.
- No: Use the Concrete Removal Calculator estimate as a planning benchmark and compare complete scopes.
How to Check a Contractor’s Concrete Removal Quote
The easiest first comparison is to convert every quote to the same unit. That exposes large differences without assuming that the lowest number represents the best scope.
US: Contractor Quote ÷ Concrete Area = Effective Cost per sq ft
UK: Contractor Quote ÷ Concrete Area = Effective Cost per m²
Compare the result with your Concrete Removal Calculator range, then confirm what each contractor actually includes.
If a US contractor quotes $3,000 for 500 sq ft, the effective price is $6 per sq ft. A £4,000 quote for 50 m² works out to £80 per m². These are simple mathematical examples, not suggested market prices.
The next question matters more: what is included? One contractor may quote demolition and loading only, while another includes saw cutting, reinforcement separation, haul-away, tipping charges, cleanup, and basic grading.
Also check taxes or VAT where applicable, equipment mobilization, exclusions, site restoration, and how unexpected thickened areas or hidden footings are priced. Permit requirements vary by municipality and project scope.
Concrete Removal Quote Checklist
- Confirm the measured concrete area and estimated thickness.
- Ask whether reinforcement cutting and separation are included.
- Confirm who pays hauling, tipping, recycling, and disposal charges.
- Ask whether equipment delivery and crew mobilization are included.
- Check whether final cleanup, backfilling, or grading is included.
- Confirm permit responsibilities where applicable.
- Ask how unexpected thickened edges, foundations, or footings will be priced.
- Confirm whether taxes or VAT are included where applicable.
Hidden Costs That Can Change a Concrete Removal Estimate
Minimum mobilization charges: A contractor may have a minimum project value even when the slab is tiny.
Multiple disposal loads: A project that exceeds the planned truck, dumpster, or skip allowance can create another haul and another disposal charge.
Overweight container charges: Concrete’s density makes weight limits especially relevant. Confirm the provider’s material-specific rules before choosing a container.
Unexpected thickened sections: Driveway edges, equipment pads, foundations, or previous structural work may contain more material than an average thickness assumption suggests.
Embedded steel: Rebar or mesh may only become obvious once demolition starts, especially where original construction records are unavailable.
Protection and restoration: Moving debris through a finished yard, house, narrow side passage, or shared access area can require surface protection and additional cleanup.
Post-removal work: Backfill, compaction, grading, drainage corrections, or preparation for replacement construction are separate from simply making the old slab disappear.
A good Concrete Removal Calculator gives you a budget framework. A good written quote tells you which of these uncertainties are already priced and which become change-order risks.
Concrete Removal in the United States vs United Kingdom
| Topic | United States | United Kingdom |
|---|---|---|
| Common area unit | Square feet | Square metres |
| Typical thickness unit | Inches | Millimetres |
| Currency | USD | GBP |
| Heavy waste container terminology | Dumpster / roll-off container | Skip |
| Waste terminology | C&D debris, tipping or dump fees | Construction and demolition waste, disposal/tipping charges |
| Waste oversight terminology | Federal, state, and local requirements; EPA provides national environmental guidance | Environment Agency/GOV.UK guidance plus applicable local requirements |
| Quote/tax treatment | Sales tax and quote practices vary | Check whether VAT is included where applicable |
The key distinction is not vocabulary alone. Pricing, permitted waste routes, contractor practices, taxation, and local requirements differ between markets. That is why a US Concrete Removal Calculator result should not simply be converted from dollars to pounds to estimate a UK project.
Concrete Recycling and Disposal
Broken concrete does not automatically need to become landfill waste. The US Environmental Protection Agency identifies concrete among construction and demolition materials that can be diverted through reuse and recycling, and notes applications for recovered materials. See the EPA guidance on construction and demolition materials.
EPA material-specific data also show how large the construction and demolition waste stream is in the United States: the agency reports about 600 million tons of C&D debris generated in 2018, with aggregate representing a major destination category. The dataset is historical rather than a current annual estimate, so it should be labeled by year. See EPA construction and demolition debris data.
For England, waste must be classified appropriately before collection, disposal, or recovery where the guidance applies. GOV.UK explains this process in its UK construction and demolition waste classification guidance.
Before assuming recycling is cheaper, check the practical details. Facilities may distinguish clean concrete from loads contaminated with soil, wood, plaster, asphalt, or other waste. Distance matters too; a recycling option that requires a long haul can change both cost and logistics.
Case Study: Same Area, Very Different Removal Work
Illustrative residential estimating scenario
Consider two 400 sq ft slabs. Neither represents a real HomeCostHub client; the comparison is designed to show how the variables behind a Concrete Removal Calculator interact.
Project A: Patio
- 400 sq ft
- 4 inches thick
- Plain concrete
- Open access
- No known reinforcement
The slab contains about 133.3 cubic feet, or 4.94 cubic yards, of solid concrete. Using the 150 lb/ft³ planning assumption gives roughly 10 short tons of concrete.
Project B: Reinforced Backyard Slab
- 400 sq ft
- 6 inches thick
- Rebar present
- Restricted backyard access
Project B contains 200 cubic feet, or about 7.41 cubic yards—50% more concrete than Project A before reinforcement is counted. Using the same density assumption gives roughly 15 short tons.
The difference is not limited to five additional tons. Rebar must be dealt with, restricted access can slow removal and loading, and larger debris quantity increases hauling demand. A square-foot-only estimate would hide all of those differences.
This illustrates the strongest reason to use the Concrete Removal Calculator as more than a multiplication tool: surface area is only the starting measurement.
Expert Tips for a More Reliable Concrete Removal Estimate
- Measure exposed thickness when possible. Replacing an assumed 4-inch thickness with an observed measurement can materially change the calculated volume.
- Separate “remove” from “remove and replace.” A quote that includes a new slab cannot be compared directly with demolition-only pricing.
- Ask about haul-away in writing. “Demolition included” does not always mean transportation and disposal are included.
- Check container weight rules before renting. Concrete can reach a payload limit well before a container is visually full.
- Do not assume thickness is uniform. Driveways and structural areas can have thickened edges or deeper local sections.
- Ask how concealed concrete is priced. Hidden footings or old foundations can turn a fixed-looking estimate into a change-order discussion.
- Locate utilities before destructive work. Cost planning should never override basic site safety.
- Compare scope before unit price. A slightly higher quote that includes hauling, disposal, cleanup, and grading may be cheaper than a low demolition-only quote after extras are added.
Common Concrete Removal Estimating Mistakes
1. Calculating Only From Surface Area
Square footage or square metres tell you footprint, not concrete quantity. Add thickness before judging how large the demolition job really is.
2. Guessing Slab Thickness
A 6-inch slab contains 50% more concrete than a 4-inch slab of the same area. A poor thickness assumption can distort volume, weight, and hauling estimates at once.
3. Ignoring Reinforcement
Concrete may break while the steel continues to hold sections together. Reinforcement can add cutting, handling, and separation work.
4. Forgetting Debris Weight
A slab that looks modest on a plan can weigh several tons. Transport and container limits should be checked before demolition starts.
5. Comparing Removal With Removal-and-Replacement Pricing
New base preparation, forming, reinforcement, pouring, and finishing belong to replacement work, not the demolition-only benchmark.
6. Assuming a Dumpster Can Be Filled to the Top
Dense material can reach a legal or contractual weight limit while substantial empty volume remains.
7. Ignoring Contractor Minimum Charges
Mobilization and equipment logistics can make small jobs expensive per sq ft or m².
8. Overlooking Access
Open driveway access and a slab behind a narrow side gate can require very different handling strategies even when the concrete quantity is identical.
9. Assuming Permit Rules Are the Same Everywhere
Permit requirements vary by municipality and project scope. Local verification is more reliable than applying a national assumption.
10. Treating Landfill as the Only Disposal Option
Clean concrete can often have recycling or recovery options, subject to local facility rules and contamination requirements. EPA specifically identifies concrete as a commonly recoverable C&D material in many locations.
Concrete Removal Myths vs Facts
Area matters, but thickness, reinforcement, access, equipment, hauling, and disposal can materially change the final cost.
Concrete is extremely dense, so a container may reach its allowable weight before its available volume is filled.
DIY may save labor on suitable small jobs, but tool rental, transport, disposal, heavy handling, and unexpected reinforcement can reduce or erase the savings.
Localized cracks or surface deterioration may sometimes be candidates for repair, resurfacing, or leveling when the slab remains serviceable.
Rebar and reinforcing mesh can add cutting, separation, handling time, and equipment requirements even when the slabs have the same dimensions.
Practical Concrete Removal Scenarios
Small Patio Slab
For a small accessible patio, contractor minimum charges may matter more than the headline price per sq ft. A DIY comparison should include disposal and lifting, not just breaker rental.
Reinforced Driveway
A driveway with rebar combines substantial concrete weight with steel separation. Thickness may also vary around edges or heavily loaded areas, so the Concrete Removal Calculator result is stronger when measurements replace assumptions.
Narrow-Access Backyard Slab
The challenge may be moving debris rather than breaking it. If machinery cannot reach the slab, handling distance and protection of finished surfaces can become major planning issues.
Garage Floor
Indoor or enclosed demolition introduces access, dust-control, surrounding-structure, and potential utility considerations that are less prominent on an open patio.
UK Garden Concrete Pad
A UK homeowner should calculate volume in m³ and weight in metric tonnes, then confirm the chosen skip or waste contractor will accept the quantity and material. Published £/m² benchmarks are useful only after scope and disposal assumptions are aligned.
Concrete Removal Calculator FAQs
How much does it cost to remove concrete?
Current published residential benchmarks vary widely. Angi cites about $2–$6 per sq ft for old concrete patio removal in the US, while MyBuilder cites roughly £50–£150 per m² for UK concrete removal. Project-specific conditions can move costs outside these ranges.
How much does concrete removal cost per square foot?
Angi currently cites roughly $2–$6 per sq ft for removal of old concrete patio material including demolition and disposal, but local labor, thickness, reinforcement, access, and scope affect actual bids.
How much does concrete removal cost per m² in the UK?
MyBuilder’s January 2026 guide cites a typical UK range of about £50–£150 per m², depending on size, thickness, and disposal requirements. Treat that figure as a market benchmark rather than a fixed national tariff.
How do you calculate concrete removal cost?
Start by measuring area and thickness to estimate concrete volume, then account for reinforcement, access, demolition method, labor, hauling, and disposal. The Concrete Removal Calculator combines these planning variables into an estimated range.
How much does it cost to remove a concrete slab?
The answer depends more on the slab’s volume and site conditions than on its label. Measure length, width, and thickness, identify reinforcement if possible, and compare the resulting estimate with complete contractor scopes.
How much does it cost to remove a concrete driveway?
Driveway removal can fall above or below generic concrete benchmarks depending on area, thickness, reinforcement, machine access, and disposal. Thickened edges and old reinforcement are common reasons a driveway quote may differ from a simple area-based estimate.
Does reinforced concrete cost more to remove?
It commonly requires more demolition effort because rebar or mesh can hold broken concrete together and may need separate cutting or handling.
How much does broken concrete weigh?
A useful planning assumption for normal concrete is about 150 lb per cubic foot, or roughly 2,400 kg/m³, though actual concrete varies. Multiply estimated solid volume by the density assumption to approximate weight.
Can concrete go in a dumpster?
Often yes, but only if the rental provider accepts concrete and the load stays within its material and weight rules. Never assume a general-purpose dumpster can be filled completely with concrete.
Can concrete go in a skip in the UK?
Many skip providers accept concrete or inert rubble under specific terms, but container size, weight limits, mixed-waste restrictions, and pricing vary. Confirm the exact material and estimated tonnage with the provider.
Can old concrete be recycled?
Yes. EPA guidance identifies concrete as a construction and demolition material that can be recovered or recycled, including into aggregate applications where appropriate.
Is DIY concrete removal cheaper?
It can be cheaper for a small, suitable project when labor savings exceed tool, transport, and disposal costs. Large, reinforced, thick, restricted-access, or structural work can make professional removal more practical.
Can I remove a concrete patio myself?
A small accessible patio may be a realistic DIY candidate for an appropriately equipped and capable homeowner, but weight, reinforcement, utilities, dust, equipment use, and disposal should be assessed before deciding.
Do you need a jackhammer to remove concrete?
Not every slab requires the same equipment. Appropriate demolition tools depend on thickness, strength, reinforcement, area, access, and how much concrete needs to be removed.
Is a mini excavator better than a jackhammer for a large slab?
A machine can be more practical for some large accessible slabs, but access, operator competence, surrounding structures, utilities, attachments, and disposal logistics all affect the decision.
How long does concrete removal take?
There is no reliable universal duration. A small open slab and a reinforced slab with restricted access can have completely different schedules even at the same surface area.
Do I need a permit to remove concrete?
Permit requirements vary by municipality and project scope. Check the relevant local authority before work begins, particularly where demolition affects structures, public access, drainage, utilities, or the street.
Should cracked concrete be repaired or removed?
Localized or cosmetic damage may be repairable, while severe displacement, widespread deterioration, structural problems, or a planned layout change may justify removal. Seek professional assessment where structural condition is uncertain.
Why is my contractor quote higher than the Concrete Removal Calculator estimate?
The quote may include mobilization, saw cutting, equipment, haul-away, disposal, taxes, cleanup, grading, or site-specific work that is not fully represented by a preliminary estimate. Compare scope line by line before comparing totals.
Why can a small concrete removal project cost so much per square foot?
Fixed costs such as crew mobilization, equipment delivery, disposal minimums, travel, and cleanup are spread across fewer square feet, raising the effective unit price.
About the Author
Arden Cole Linscott
Expert — Residential Construction & Remodeling Cost Analysis
Arden Cole Linscott specializes in residential construction and remodeling cost analysis, project budgeting, and practical cost guidance for homeowners. His HomeCostHub content focuses on translating construction measurements, contractor pricing, project scope, and real-world cost variables into clearer planning decisions without presenting preliminary estimates as guaranteed bids.
What to Do With Your Concrete Removal Estimate
Start with the measurements. Verify length and width, then confirm slab thickness wherever it can be observed safely instead of relying on a default assumption. Identify known reinforcement and check whether your disposal estimate reflects the likely weight of the concrete rather than surface area alone.
When contractor quotes arrive, compare complete scopes. A low demolition price can become expensive if hauling, tipping charges, reinforcement cutting, cleanup, or grading are added later. Likewise, a higher initial quote may already include work another contractor lists separately.
Use the Concrete Removal Calculator as a planning benchmark: a way to understand the scale of the work, test assumptions, and ask better questions. The closer your measurements and project conditions match the actual slab, the more useful that estimate becomes when you move from online budgeting to a site-specific quote.
