DIY Kitchen Remodel Calculator

DIY Kitchen Remodel Calculator Cost Guide
A DIY Kitchen Remodel Calculator helps homeowners estimate the potential cost of completing some or most kitchen renovation work themselves instead of hiring a contractor for every task.
DIY remodeling can reduce labour cost, but homeowners still need to budget for materials, tools, installation supplies, demolition, delivery, waste, and specialist trades that may require professional help.
This cost calculator supports both USA cost and UK cost estimates in USD or GBP and accepts kitchen size in square feet or square meters. It separates material cost, labour cost, installation cost, additional expenses, and removal cost to provide a practical price estimate for cosmetic updates, partial renovations, full DIY kitchen remodels, and hybrid projects where homeowners handle suitable tasks while licensed professionals complete specialized work.
DIY Kitchen Remodel Calculator
Estimate DIY kitchen remodeling costs in the USA or UK based on kitchen size, material package, quality level, project scope, existing condition, installation approach, labour difficulty, removal work, and optional upgrades that may still require tools or specialist help.
Material / Project Types
DIY kitchen remodeling projects can use a wide range of material packages depending on budget, experience, and the desired finish.
Economy or ready-to-assemble materials are often suitable for Budget DIY projects. Flat-pack cabinets, laminate countertops, click-lock flooring, standard fixtures, and readily available hardware can help reduce both material cost and installation complexity.
Standard DIY remodeling materials provide a balance between affordability, durability, and appearance. These may include ready-to-assemble or semi-custom cabinets, standard countertops, mid-range flooring, backsplash tile, fixtures, and common trim products.
Premium DIY materials can include higher-quality cabinets, quartz surfaces, premium flooring, upgraded sinks, decorative hardware, and better fixtures. These products increase material cost and can require more precise installation.
Custom or cut-to-fit materials may include specialized cabinetry, custom panels, fabricated countertops, detailed trim, and products that require accurate measurement and fitting. DIY installation becomes more demanding when materials are less forgiving of mistakes.
Designer or specialty materials may include Luxury surfaces, specialty tile, imported products, premium hardware, and high-end finishes. These materials can be expensive to replace if damaged during DIY installation, so additional waste and contingency allowances may be useful.
Project scope also matters. A cosmetic refresh can involve painting, hardware, backsplash, and fixtures, while a full DIY remodel may include demolition, cabinets, countertops, flooring, appliances, and finish work.
Main Factors Affecting Cost
Kitchen size is one of the main cost factors because larger kitchens require more cabinets, countertops, flooring, trim, paint, fixtures, and installation supplies.
Material quality also has a major effect on the price estimate. Budget products generally reduce upfront spending, while Premium and Luxury products can increase material cost substantially.
Project type determines how much of the existing kitchen will be replaced. A cosmetic update generally costs less than a partial remodel, while a full DIY renovation can involve most major kitchen components.
Existing condition affects replacement cost and repair cost. Damaged walls, leaking plumbing, deteriorated flooring, outdated wiring, or hidden moisture problems can require repairs before new materials are installed.
Installation type affects how much paid labour remains in the project. A mostly self-installed renovation uses a lower professional labour allowance, while a hybrid project assumes more specialist assistance.
Labour difficulty also matters even when homeowners perform much of the work themselves. Complex cabinet layouts, uneven walls, stone surfaces, plumbing changes, electrical upgrades, and difficult access can increase tool requirements, waste, installation time, and professional support costs.
Additional expenses can include tool purchases or rentals, cabinet packages, countertops, flooring, licensed plumbing or electrical work, delivery charges, waste, and contingency materials.
Cost Breakdown
Material Cost: Material cost usually represents the largest portion of a DIY kitchen remodel. It includes cabinets, countertops, flooring, fixtures, finishes, fasteners, adhesives, hardware, and other remodeling products.
Labour Cost: Labour cost represents professional help that may still be needed even in a DIY project. This can include licensed electrical work, plumbing, specialist fabrication, complex carpentry, or other tasks the homeowner does not complete independently.
Installation Cost: Installation cost covers paid installation support, specialty fitting, fabrication, or assistance associated with the selected DIY approach. A mostly self-installed project generally has a lower installation allowance than a hybrid remodel.
Additional Cost: Additional expenses can include tools, rentals, DIY cabinet replacement, countertop upgrades, flooring, licensed trade assistance, delivery, waste, and contingency allowances. Basic, Standard, and Advanced feature levels adjust these amounts.
Removal Cost: Removal cost represents demolition, disposal, skip or dumpster fees, hauling, and other costs associated with taking out existing kitchen materials. If the homeowner performs all removal without additional expense, this option can be turned off and the category will remain visible at zero.
The calculator combines material cost, labour cost, installation cost, additional cost, and removal cost to generate an estimated total DIY kitchen remodeling price.
Why Use This Calculator?
The DIY Kitchen Remodel Calculator provides a practical starting point for homeowners deciding whether doing part of a renovation themselves could reduce overall project costs.
It allows several strategies to be compared before purchasing materials. Homeowners can compare a cosmetic refresh with a full DIY remodel, evaluate Budget against Premium materials, or see how limited professional assistance changes the estimated cost.
The calculator also helps identify expenses that are sometimes overlooked in DIY budgets. Tools, saw blades, fasteners, adhesives, delivery fees, waste, replacement materials, disposal, and specialist trades can add significantly to the final cost.
Some work may also require licensed or qualified professionals depending on local rules and the specific project. Electrical service changes, gas work, major plumbing alterations, structural modifications, and some permitted work should be evaluated according to applicable local requirements.
USA and UK pricing are selected independently from measurement units. USA estimates are displayed in dollars, while UK estimates are shown in pounds. Users can enter kitchen size in square feet or square meters regardless of country. Square-meter inputs are converted internally using 1 square meter = 10.7639 square feet while the original measurement unit remains visible in the result.
The output is intended as a preliminary budget rather than a supplier or contractor quotation, but it provides a useful starting point for comparing DIY installation cost, replacement cost, repair cost, USA cost, UK cost, price estimate, material cost, and labour cost.
DIY Kitchen Remodel Calculator: Turn Your Estimate Into a Realistic Plan
A DIY Kitchen Remodel Calculator gives you a useful preliminary budget, but the number becomes realistic only after you separate work you can safely handle from paid specialist work and allow for tools, waste, delivery, rework, and contingency.
A lower DIY estimate can look attractive on paper. The real test is whether those savings survive once work begins.
Removing cabinets yourself may genuinely reduce paid labor. Installing hardware can be manageable. Painting is forgiving. But a badly measured cabinet run, damaged worktop, plumbing leak, or electrical mistake can wipe out several smaller savings at once.
That is why the useful question is not simply, “How much can I save by doing the kitchen myself?” It is:
Which parts of this remodel provide worthwhile DIY savings without creating disproportionate cost or safety risk?
A practical DIY budget separates tasks by consequence, not pride. It also treats the calculator result as the starting point for decisions rather than a guaranteed final price.
Use the estimate as a range, not a quote.
Protect contingency until demolition and hidden conditions are understood.
DIY low-risk labor where mistakes are inexpensive to correct.
Price professional work before assuming you will complete it yourself.
Account for tools, consumables, waste, delivery, and rework when measuring DIY savings.
Keeping the existing kitchen layout can prevent one change from triggering several other trades.

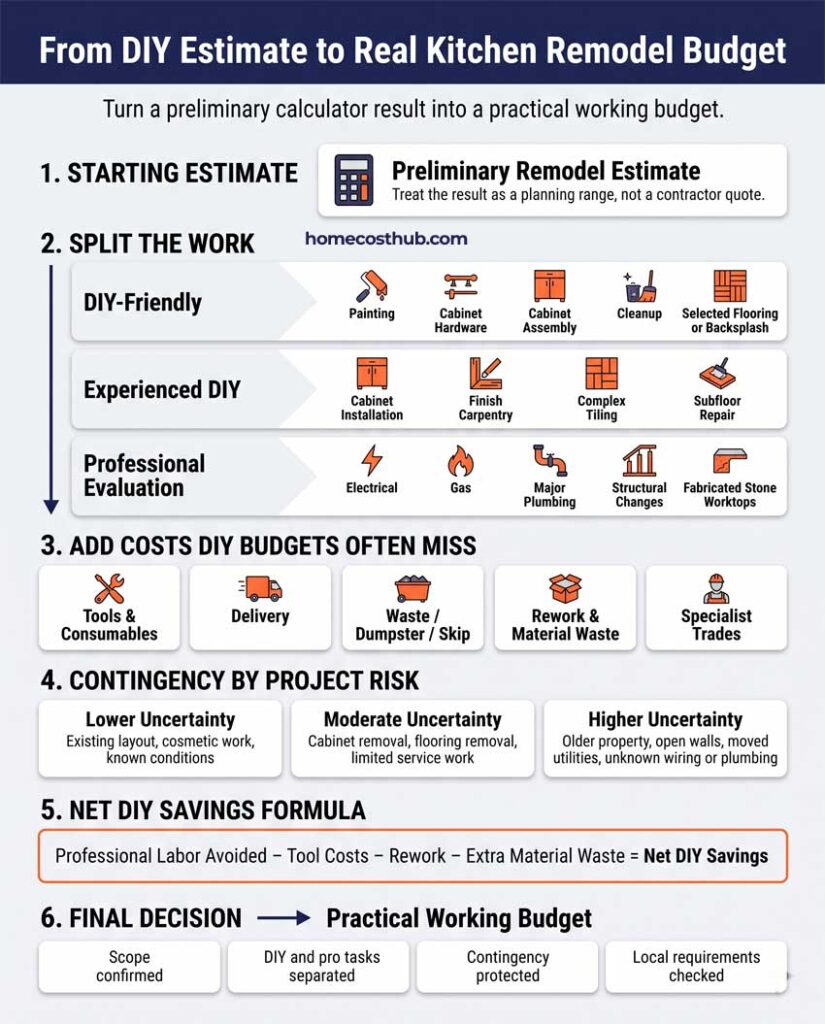

How to Read Your DIY Kitchen Remodel Calculator Estimate
A DIY Kitchen Remodel Calculator works best as an early budgeting tool. It helps establish whether the project you have in mind is broadly compatible with the amount you are prepared to spend.
The result should not be confused with a supplier quotation or contractor proposal.
There are several stages between an estimate and the amount eventually paid:
| Budget Stage | What It Means | How Much Confidence to Place in It |
|---|---|---|
| Calculator estimate | Planning range based on project assumptions | Useful for early decisions |
| Working budget | Calculator result adjusted for chosen products, DIY tasks, trades, and contingency | More useful once scope is defined |
| Supplier pricing | Actual prices for cabinets, worktops, appliances, flooring, fixtures, and delivery | Higher confidence for selected products |
| Trade quotations | Prices for plumbing, electrical, fitting, fabrication, gas, or structural work | Higher confidence when scope is clearly specified |
| Final project cost | What was actually spent after changes, repairs, waste, and unforeseen work | Known only after completion |
The biggest mistake is treating the middle of an estimated range as money already committed.
Suppose your DIY kitchen remodel estimate is $18,000–$24,000. A working budget should not simply become $21,000. First identify the uncertain items.
Perhaps cabinet pricing is already confirmed at $7,000, but electrical work has not been quoted. The floor has not been lifted, the condition of the subfloor is unknown, and the worktop still needs templating.
Those unknowns deserve more attention than the categories already fixed by supplier quotes.
A practical way to review your DIY kitchen remodel cost calculator result is to mark each major expense as:
- Confirmed: written supplier price or accepted quotation.
- Reasonably known: clear scope with reliable current pricing.
- Variable: quantity, specification, or labor still undecided.
- Unknown: conditions cannot be confirmed until demolition or investigation.
The more money sitting in the last two categories, the less useful a single exact total becomes.
The Practical DIY Kitchen Remodel Cost Formula

Materials + Paid Specialist Work + Tools and Consumables + Delivery and Disposal + Contingency = Practical DIY Remodel Budget
“Doing the labor yourself” is not the same as making labor financially free.
A task may require blades, drill bits, adhesives, tile spacers, leveling systems, protective equipment, dust control, rental equipment, or a tool you may never use again. Some work also takes several attempts before the finished result is acceptable.
There is another cost that rarely appears on an invoice: rework.
If three backsplash tiles are wasted, the financial effect may be small. If a cabinet is cut incorrectly, a floor is installed over a poorly prepared substrate, or a fabricated worktop is measured incorrectly, the loss can be much larger.
Temporary living arrangements can matter as well. A DIY kitchen remodel stretching across several weekends may mean more restaurant meals, takeaway food, laundromat trips if utility spaces are affected, or temporary cooking equipment.
Those expenses are not arguments against DIY. They are reasons to compare the true financial result rather than counting only avoided contractor labor.

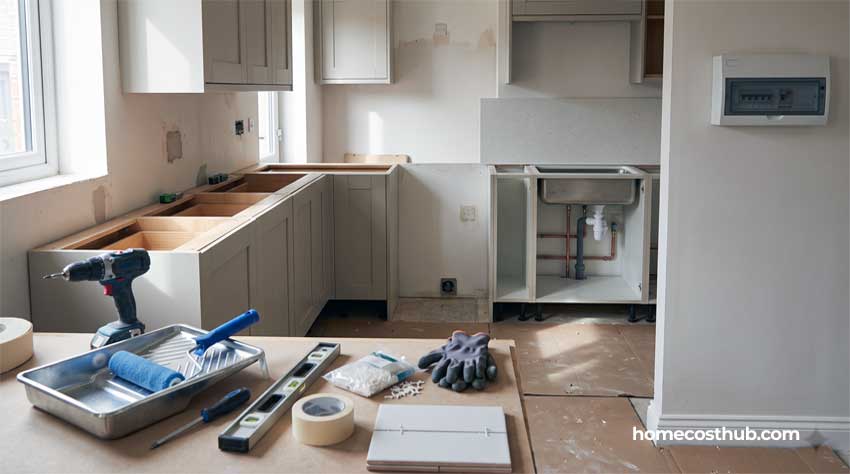

Mostly DIY vs Partial DIY vs Professional Remodel
For many homeowners, the strongest financial strategy sits between the two extremes.
A partial DIY kitchen remodel lets the homeowner keep tasks with manageable consequences while outsourcing jobs where safety, technical knowledge, specialist tools, or expensive materials raise the cost of failure.
| Approach | Homeowner Work | Professional Work | Potential Savings | Skill Requirement | Risk | Best For |
|---|---|---|---|---|---|---|
| Mostly DIY | Most removal, fitting, finishing, and coordination | Limited specialist tasks | Potentially highest gross labor saving | High | Highest homeowner exposure to mistakes and delays | Experienced renovators with time and tools |
| Partial DIY / Hybrid | Demolition, painting, assembly, hardware, selected flooring or tiling | Electrical, complex plumbing, fabrication, gas, structural or difficult fitting | Moderate to strong | Moderate | Balanced | Most capable homeowners |
| Professionally Managed | Selections and owner decisions | Most construction and installation | Lowest DIY labor saving | Low homeowner installation skill | Lower direct workmanship risk, but contractor selection remains important | Complex projects or owners with limited time |
HomeGuide’s 2026 US cost data places DIY kitchen renovations at about $10,500–$42,500 and professionally completed projects at about $15,000–$50,000 for its average/full-remodel category. It estimates DIY savings at roughly 15%–30%, but that percentage should be treated as a benchmark rather than a promise because location, scope, materials, and homeowner ability vary.
The useful number is not the percentage somebody else saved. It is the money you avoid paying after subtracting the costs created by doing the work yourself.
Which Kitchen Remodel Jobs Are Realistically DIY-Friendly?

The safest way to classify a kitchen job is by the consequence of getting it wrong.
Difficulty matters, but consequence matters more.
Generally DIY-Friendly for Capable Homeowners
Depending on the property and individual skill level, lower-risk work can include:
- painting walls and ceilings
- replacing cabinet knobs and pulls
- assembling ready-to-assemble cabinets
- installing simple shelving
- carefully removing cabinets and finishes after safety checks
- basic cosmetic trim
- some click-lock flooring installations
- backsplash tiling for homeowners who understand substrate preparation and layout
- site cleanup and debris organization
These jobs can still be done badly, but mistakes often remain comparatively localized and repairable.
Tasks That Demand More Installation Experience
The next category is less forgiving:
- hanging and leveling cabinets
- installing long cabinet runs on uneven walls
- finish carpentry
- repairing damaged subfloor
- complex tile layouts
- fitting timber or laminate worktops
- installing flooring around difficult transitions
- accurately integrating fillers and end panels
Cabinet installation illustrates the problem well. The individual box may be simple, but an error at the beginning of a run can multiply across every cabinet that follows.
Work That Often Deserves Qualified Professional Evaluation
Professional involvement becomes more compelling when the job involves:
- new electrical circuits or service changes
- gas work
- significant supply or waste-pipe relocation
- structural alterations
- wall removal
- complex ventilation routing
- heavy or fabricated stone worktops
- work subject to local permits, notification, inspection, or specialist qualification requirements
Requirements vary by jurisdiction, so “I have seen someone do this online” is not evidence that the same work is legal or appropriate at your property.
Choose DIY work partly by the financial consequence of an error. A poor paint finish may require sanding and another coat. A badly cut fabricated worktop, damaged cabinet, leaking connection, or unsafe electrical alteration can erase the savings from several successful low-risk DIY tasks.
Where DIY Kitchen Remodeling Can Produce Real Savings
The most attractive DIY jobs usually combine three characteristics:
- The professional version contains meaningful labor.
- The homeowner already has or can reasonably learn the required skill.
- A mistake is relatively inexpensive to correct.
Demolition can fit that profile when the work does not involve unknown hazardous materials, live services, or structural components.
Painting is another example. The process is labor-intensive, yet the cost of correcting a poor finish is usually manageable.
Cabinet assembly may also produce worthwhile savings when units arrive flat-packed or ready to assemble. Assembly and installation should not be treated as identical tasks, however. Building boxes on a level floor is different from setting an entire cabinet run accurately against walls that may not be straight.
Other potential savings areas include:
- removing and refitting hardware
- selected backsplash work
- site preparation
- cleanup
- simple finish work
- material procurement and scheduling
- selected flooring where the substrate is suitable
The DIY Kitchen Remodel Calculator estimate becomes more useful when these tasks are separated from specialist work rather than applying one broad “DIY discount” to the whole renovation.
A homeowner may save heavily on painting and cleanup but nothing on quartz fabrication. That is normal.
Where DIY Can Become More Expensive Than Hiring the Job Out

A DIY decision becomes financially weak when the cost of mistakes approaches the labor saving.
Measurement Errors
Cabinets depend on more than wall length.
Door swings, fillers, appliance openings, corner clearances, worktop overhangs, service positions, and walls that are out of square can all affect the layout.
Ordering a cabinet run from nominal dimensions without checking field conditions can lead to additional fillers, reordered cabinets, or appliances that no longer fit.
Poor Substrate Preparation
Tile, flooring, cabinets, and worktops rely on what sits underneath them.
New flooring over a weak or uneven subfloor does not solve the substrate. Tile over unsuitable backing can crack. Cabinets installed against an uneven base can create alignment problems above.
Finishes often receive the blame for defects caused much earlier in the project.
Using Expensive Materials as a Learning Exercise
Premium materials change the economics of DIY.
Making a mistake on an inexpensive piece of trim is different from making the first experimental cut on a large visible end panel or worktop.
Emergency Trade Callouts
A planned plumber or electrician visit can be scheduled and priced.
An emergency call after a failed DIY attempt can be more disruptive and may involve troubleshooting before the original work can even continue.
Project Delays
A weekend project that stretches across six weeks has costs beyond inconvenience.
Trades may need rescheduling. Fabricated materials can miss installation windows. Appliances remain boxed. The temporary kitchen stays in use longer.
Time is especially important where the homeowner must take unpaid leave or repeatedly travel to collect forgotten materials.
A Decision-Oriented DIY Kitchen Remodel Cost Table
The ranges below are not substitutes for the calculator or local quotations. They illustrate which decisions tend to push a project toward a lower- or higher-cost route.
| Remodel Decision | Lower-Cost Path | Higher-Cost Path | What Usually Changes the Budget |
|---|---|---|---|
| Layout | Retain sink, cooking, and major appliance locations | Move utilities or remove walls | Additional trades, surfaces, flooring repairs, cabinetry changes |
| Cabinetry | Paint/reface viable existing boxes or use stock/RTA units | Semi-custom, custom, or bespoke units | Material specification, fitting precision, end panels, fillers |
| Countertop / worktop | Laminate or DIY-manageable timber where appropriate | Fabricated quartz, granite, or premium stone | Templating, fabrication, transport, specialist installation |
| Flooring | Suitable DIY-friendly product over sound substrate | Complex tile, hardwood, or extensive substrate repair | Preparation, cutting, leveling, labor |
| Appliances | Retain serviceable units and existing locations | Replace multiple units or change fuel/service requirements | Purchase price, electrical/gas/plumbing changes |
| Trade involvement | Schedule specialists for narrowly defined work | Multiple trades plus layout and service relocation | Labor, coordination, inspections, dependencies |
For context, HomeGuide’s January 2026 US benchmark puts DIY kitchen remodels at roughly $50–$175 per square foot and $10,500–$42,500 for an average renovation, while its professional comparison starts higher.
For the UK, Checkatrade’s March/June 2026 estimates list average-sized kitchen fitting labor at about £3,500, with a broad £2,000–£6,000 range depending on scope and complexity. Its broader new-kitchen cost data separates units, worktops, installation, plumbing, electrics, and flooring rather than presenting one universal price.
These figures demonstrate why US pricing should not simply be converted into pounds. The labor market, tax treatment, product supply, terminology, trade structure, and regional variation are different.
Why Keeping the Existing Kitchen Layout Can Protect Your Budget
Keeping the existing layout does more than avoid moving a sink.
It reduces the number of project systems that need to interact.
Imagine a homeowner moves the sink from the wall to a new island.
The change may involve:
- new water-supply routing
- new waste routing
- floor or subfloor access
- changes to cabinet configuration
- a different worktop layout
- possible electrical requirements for island outlets
- floor repairs where the old sink base was removed
Moving the cooking zone can create similar dependencies involving ventilation, gas or electrical supply, cabinetry, worktops, and wall finishes.
A “small layout improvement” can therefore create several invoices.
BuildBank’s 2026 UK renovation guide identifies layout changes as a major cost driver and estimates that moving plumbing and electrical points can add thousands of pounds to a kitchen project. That is a commercial benchmark rather than a regulatory price schedule, but it demonstrates the cascading-cost principle.
Illustrative Same-Layout Scenario
Assume a homeowner has a working budget of about $20,000 for a partial-DIY project.
Keeping the sink, dishwasher, and range in their existing locations allows most of that budget to remain focused on visible improvements.
Now assume the redesign relocates the sink and adds an island with electrical service.
The homeowner may not merely pay for “moving a sink” and “adding an outlet.” Cabinet plans, worktop dimensions, flooring repairs, service routing, inspection requirements, and project sequencing may all change.
The exact cost depends on the property. The financial lesson is more reliable than any fixed price: layout changes often create chains of related work.
The Tool Cost Trap: Gross Savings vs Net Savings
A DIY budget often counts the contractor labor avoided but forgets what was purchased to replace that labor.
A garage already equipped with good tools changes the equation. A first-time remodeler starting with a screwdriver set faces a different calculation.
Common project purchases can include:
- drill and driver accessories
- saw blades
- oscillating-tool blades
- levels
- clamps
- tile-cutting equipment
- sanding equipment
- dust extraction or a shop vacuum
- PPE
- adhesives
- fasteners
- caulk and sealants
- temporary work lighting
Some tools have long-term value. Others are bought for one task and then stored indefinitely.
Rental can make more sense for equipment that is expensive, bulky, rarely used, or needs to be particularly capable to complete one job efficiently.
Professional Labor Avoided − Tool Costs − Rework − Extra Material Waste = Net DIY Savings
Suppose a homeowner avoids a $2,000 installation charge but spends $650 on tools, wastes $250 of material, and pays $400 for professional correction.
The gross labor saving was $2,000.
The simplified net saving falls to $700.
That does not mean DIY was a failure. It means the financially useful number is $700, not $2,000.
How Much Contingency Should a DIY Kitchen Remodel Carry?
Contingency should reflect uncertainty rather than habit.
A percentage chosen without looking at project risk is simply another guess.
Lower-Uncertainty Project
Examples:
- existing layout retained
- relatively modern property
- no walls opened
- cosmetic work
- known electrical and plumbing condition
- most products already selected
A smaller contingency may be reasonable because fewer unknowns remain.
Moderate-Uncertainty Project
Risk increases where the project involves:
- cabinet removal
- flooring removal
- limited service updates
- new appliances
- some concealed conditions
A middle-range contingency becomes easier to justify.
Higher-Uncertainty Project
Allow more protection where the kitchen involves:
- older construction
- previous undocumented renovations
- walls or floors being opened
- layout changes
- unknown wiring or plumbing
- water damage
- structural changes
Commercial renovation guides commonly suggest contingencies around 10%–15% or higher depending on risk; Checkatrade’s broader 2026 renovation guidance recommends 10%–15% for unexpected costs, while BuildBank uses 15% in its kitchen/bathroom forecasting model. Those are planning benchmarks, not universal rules.
Contingency should remain protected for uncertainty.
Using half of it early to upgrade appliances defeats its purpose.
US vs UK DIY Kitchen Remodeling Considerations
The remodeling logic is similar in both markets, but terminology and regulatory systems are not interchangeable.
| Topic | United States | United Kingdom |
|---|---|---|
| Currency | USD | GBP |
| Common area unit | Square feet | Square metres |
| Cabinet terminology | Cabinets | Kitchen units |
| Surface terminology | Countertop | Worktop |
| Wall finish | Backsplash | Splashback |
| Waste container | Dumpster | Skip |
| Electrical requirements | Codes, permits, and licensing vary by state/local jurisdiction | Building Regulations apply according to jurisdiction; Approved Document P covers electrical safety in dwellings in England |
| Permission / compliance | Check local building department for applicable permits and inspections | Check applicable Building Regulations and local authority/building control requirements |
GOV.UK states that Approved Document P concerns electrical safety in dwellings in England and explains when notification of work is required.
That wording matters. It should not be presented as if the same Approved Document automatically governs Scotland, Wales, Northern Ireland, or the United States.
Safety and Compliance Before Starting DIY Work
Budget savings stop being meaningful when work creates avoidable health or safety risks.
United States: Older Homes and Lead-Based Paint
The U.S. Environmental Protection Agency warns that renovation, repair, or painting work in pre-1978 homes containing lead-based paint can create hazardous lead dust.
EPA recommends that homeowners planning this type of renovation consider hiring lead-safe certified contractors. Homeowners who decide to perform the work themselves are advised to follow lead-safe DIY practices such as containing the work area, minimizing dust, using appropriate protection, controlling waste, and cleaning thoroughly.
See the EPA lead-safe renovation guidance for DIYers.
There is an important legal distinction.
EPA states that the federal Renovation, Repair and Painting Rule generally does not apply to homeowners performing renovation work in their own owner-occupied homes. Different requirements can apply where renovation is performed for compensation, in rental property, certain childcare settings, or in house-flipping activity.
See the EPA Renovation, Repair and Painting Program for current federal guidance.
State or local requirements can add further obligations, so federal information should not be treated as the only possible requirement.
United Kingdom: Electrical and Building Regulation Considerations
For England, Approved Document P electrical safety guidance covers electrical safety in dwellings and explains notification considerations.
A kitchen project does not automatically require Building Regulations approval simply because a kitchen is being updated. The work being carried out determines which requirements apply.
For broader guidance, consult GOV.UK Building Regulations approval guidance and the applicable building-control authority before regulated work begins.
Gas, structural, and specialist electrical work deserve particular care. Professional involvement is not simply a budget line; in some situations it is part of meeting the applicable safety and compliance framework.
Pros and Cons of a DIY Kitchen Remodel
| Pros | Cons |
|---|---|
| Can reduce paid labor on suitable tasks | Often takes longer than professional installation |
| Greater control over purchasing | Learning mistakes can consume savings |
| Allows work to be phased around cash flow | Specialist tools can be expensive |
| Flexible scheduling for cosmetic work | Household disruption may last longer |
| Useful skills and tools may carry into future projects | Some warranties or products may have installation conditions |
| Can reserve budget for high-value professional work | Regulated and safety-critical work still needs proper evaluation |
The strongest DIY strategy is rarely defined by doing the largest possible number of jobs yourself.
It is defined by retaining the jobs where your time produces useful savings and outsourcing the jobs where the consequence of error is too high.
Decision Tree: Should You DIY This Kitchen Remodel Task?
Use this sequence before assigning a job to yourself.
1. Could an error create significant electrical, gas, structural, fire, or water-damage risk?
- Yes: Stop and obtain qualified professional advice.
- No: Move to Question 2.
2. Is the work regulated, permit-controlled, notifiable, or subject to local licensing requirements?
- Yes or unsure: Verify requirements before beginning.
- No: Move to Question 3.
3. Have you successfully completed comparable work before?
- Yes: Move to Question 4.
- No: Compare the cost of tools, learning time, and possible rework against a professional quotation.
4. Is the material expensive, custom-made, difficult to repair, or hard to replace?
- Yes: Professional installation may provide better risk-adjusted value.
- No: Move to Question 5.
5. Do you already own or reasonably have access to the required tools?
- No: Add purchase or rental cost before calculating savings.
- Yes: Move to Question 6.
6. Will DIY delay another trade or product installation if the task takes longer than expected?
- Yes: Price the scheduling risk before proceeding.
- No: DIY may be financially reasonable if the remaining risks are acceptable.
This is a budgeting and project-planning framework, not legal or trade advice.
DIY Kitchen Remodel Planning Checklist
- Confirm the project scope before ordering materials.
- Separate DIY tasks from specialist and professional trade work.
- Verify cabinet, appliance, sink, and worktop dimensions on site.
- Measure wall angles and check floors for level where cabinetry will be installed.
- Confirm required cabinet fillers and appliance clearances.
- Check local permit, inspection, or Building Regulations requirements.
- Calculate tools, consumables, delivery, and disposal before counting DIY savings.
- Set contingency according to project uncertainty.
- Confirm electrical, gas, plumbing, ventilation, and structural responsibilities.
- Create a temporary cooking and washing-up plan if the kitchen will be unusable.
- For relevant older US homes, assess lead-safe renovation precautions before disturbing painted surfaces.
- Confirm product delivery dates before removing the existing kitchen.
- Do not order fabricated worktops until the required final measurements can be confirmed.
- Keep contingency separate from the upgrade budget.
DIY Kitchen Remodel Myths That Can Distort the Budget
DIY work can still create tool, consumable, waste, rework, delivery, schedule, and specialist-support costs. Net savings matter more than gross labor avoided.
Tutorials can improve understanding, but they do not replace code knowledge, trade experience, specialist equipment, or the qualifications that may apply to safety-critical or regulated work.
A low purchase price can be offset by high waste, difficult installation, short service life, replacement, or labor required to correct poor results.
Contingency protects against uncertainty that cannot always be priced before demolition, especially in older homes or projects involving concealed plumbing, wiring, subfloors, or previous alterations.
Common DIY Kitchen Remodel Mistakes That Erase Savings
1. Ordering Cabinets Before Final Field Measurements
Design dimensions and actual room dimensions are not always the same.
Walls can bow. Corners may not be square. Plaster thickness changes. Previous work may have created irregular openings.
Financial consequence: replacement cabinets, extra fillers, modification work, or installation delay.
Prevention: verify finished dimensions at multiple points before placing a final cabinet order.
2. Ignoring Fillers and Appliance Clearances
A cabinet can technically fit between two walls while still failing functionally because the drawer hits adjacent trim or an appliance door cannot open fully.
Financial consequence: reordering, altered panels, compromised layout, or lost appliance space.
Prevention: check manufacturer clearance requirements and cabinet door/drawer swings.
3. Measuring Length Without Checking Square and Level
A 10-foot wall is not automatically a straight 10-foot installation surface.
Financial consequence: uneven worktops, cabinet alignment problems, excessive scribing, or flooring defects.
Prevention: check level, plumb, and diagonal measurements where they affect installation.
4. Underestimating Demolition Logistics
Removing a kitchen creates bulky waste quickly.
Cabinet boxes, countertops, tile, flooring, packaging, and old appliances need somewhere to go.
Financial consequence: last-minute dumpster or skip hire, extra hauling, disposal charges, and project delays.
Prevention: decide where materials will be staged and disposed of before demolition starts.
5. Treating Every Tool Purchase as an Investment
Some equipment gets reused. Some sits unused after one weekend.
Financial consequence: gross DIY savings look much larger than net savings.
Prevention: compare buy, rent, borrow, and professional-installation costs before purchasing specialty equipment.
6. Removing the Kitchen Before New Products Are Confirmed
A supplier delivery date and an expected delivery date are not always the same thing.
Financial consequence: longer kitchen downtime, repeated trade rescheduling, extra food costs.
Prevention: verify critical materials and lead times before making the existing kitchen unusable.
7. Scheduling Trades in the Wrong Sequence
A plumber cannot always finish before cabinets exist. A worktop fabricator may require cabinets to be installed first. Electrical work can have rough-in and final stages.
Financial consequence: return visits and duplicated callout charges.
Prevention: map dependencies rather than simply creating a list of trades.
8. Forgetting the Temporary Kitchen
A full renovation can leave the household without a normal sink, cooktop, or dishwasher.
Financial consequence: takeaway meals and temporary equipment gradually consume contingency.
Prevention: establish a practical temporary food-preparation area before shutdown.
9. Ordering Fabricated Surfaces Too Early
Stone and other fabricated surfaces are far less forgiving than many sheet materials.
Financial consequence: an incorrect measurement can affect an expensive finished component.
Prevention: follow the fabricator’s templating requirements and make sure cabinets are in the correct final position.
10. Treating Video Familiarity as Installation Experience
Watching an expert perform a clean installation can hide the judgment required when the room is not square, the substrate is damaged, or the original services are unusual.
Financial consequence: slower work, repeat purchases, and professional correction.
Prevention: distinguish understanding the steps from having demonstrated competence with the task.
11. Failing to Inspect After Demolition
Demolition creates a rare opportunity to see previously concealed areas.
Financial consequence: new finishes can cover unresolved leaks, damaged substrate, or wiring/plumbing problems.
Prevention: inspect the exposed structure and services before closing the area again.
12. Spending Contingency on Upgrades Too Early
An untouched contingency balance can feel like available money.
It is not.
Financial consequence: the budget has no resilience when a legitimate hidden condition appears.
Prevention: release contingency only after the major unknowns have been resolved.
Illustrative Case Study: A Partial-DIY Kitchen Remodel
This is an illustrative budgeting example, not an audited HomeCostHub customer project or a claim about typical final cost.
A US homeowner has a medium-sized kitchen and decides to retain the existing layout.
The preliminary DIY Kitchen Remodel Calculator result suggests that a renovation in the planned specification could fall around $20,000–$26,000, depending on the final products and paid trade work.
DIY Tasks Selected
The homeowner takes responsibility for:
- careful cabinet removal
- painting
- ready-to-assemble cabinet assembly
- hardware installation
- minor cosmetic finishing
- site cleanup
Professional Work Retained
The homeowner pays for:
- electrical modifications
- plumbing connection work
- final cabinet installation assistance where alignment is critical
- worktop templating and fabrication
The homeowner does not move the sink, dishwasher, or cooking zone.
That decision limits the number of systems affected by the remodel.

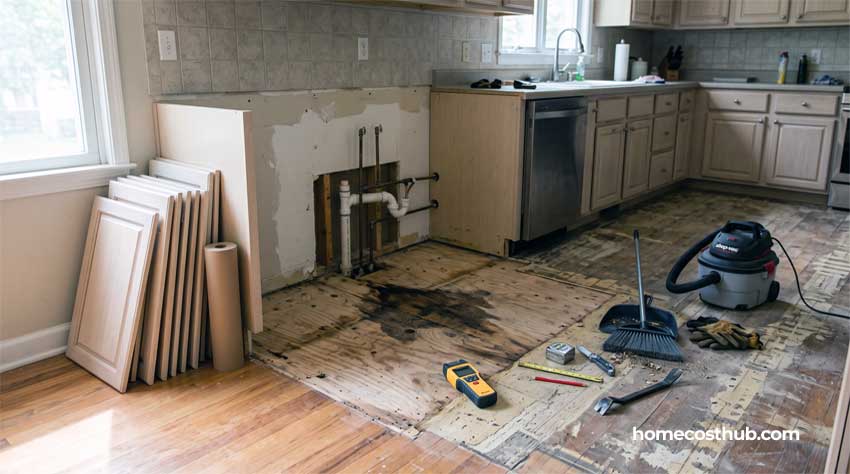

The Unexpected Issue
After the old flooring is removed, a localized section of damaged subfloor is found near the dishwasher.
The repair was not visible during initial planning.
An allowance from contingency covers the repair without forcing the homeowner to downgrade cabinets or delay the worktop order.
Working Budget
The eventual planning picture could look like this:
| Budget Item | Illustrative Amount |
|---|---|
| Cabinets and hardware | $7,000 |
| Worktop and fabrication | $4,000 |
| Flooring, backsplash, paint, and finishes | $3,200 |
| Professional electrical/plumbing/installation assistance | $3,500 |
| Tools, consumables, delivery, and disposal | $1,500 |
| Subfloor repair and other contingency use | $1,300 |
| Illustrative final spend | About $20,500 |
Suppose equivalent outsourced labor for the homeowner-completed tasks would have added roughly $4,000–$5,000 in this hypothetical scenario.
The homeowner did not “save” the full amount because DIY tools and extra consumables also cost money.
The useful saving is the avoided professional labor after those extra DIY expenses are deducted.
The strongest financial decision in this scenario was not attempting every trade. It was keeping lower-consequence labor in-house while paying specialists where the cost of getting the work wrong was substantially higher.
A Short UK Partial-DIY Example
A UK homeowner replaces kitchen units and worktops but retains the existing arrangement of the sink and main appliances.
They assemble flat-pack units, paint, install handles, and handle selected removal work. A fitter completes the cabinet installation, while appropriate trades handle electrical, plumbing, or gas work where required.
Current Checkatrade data published in 2026 places average-sized kitchen fitting labor around £3,500, with its stated range running roughly £2,000–£6,000 depending on the job.
If the owner successfully removes several days of fitting or preparation labor from the scope, there may be meaningful savings.
If poor assembly means units need correcting before the fitter can install them, some of those savings disappear.
The decision should therefore be based on the net effect rather than the number of tasks labeled “DIY.”
Professional Observations That Improve DIY Budgeting
Expensive materials change the acceptable error rate. As component value rises, professional installation can become economically rational even when the physical task looks achievable.
Older kitchens can contain several generations of alterations. One cabinet run may conceal abandoned plumbing, patched wiring routes, damaged plaster, old floor layers, or previous DIY fixes. A preliminary estimate cannot see those conditions.
Walls are drawings only until they are measured. Cabinet design software assumes clean geometry. Real rooms often require fillers, scribing, leveling, packing, and adjustments.
Utility relocation creates dependencies. A sink move can affect plumbing, cabinetry, flooring, and worktop fabrication. A cooking-zone move can affect power, gas, ventilation, wall finishes, and cabinetry.
Delivery timing can become part of labor cost. A trade arriving before the required product is on site may need to return. That second visit has a price even though the material itself did not become more expensive.
Partial DIY often produces better risk-adjusted savings than maximum DIY. The homeowner still removes real labor from the project while leaving high-consequence work to people who perform it routinely.
Frequently Asked Questions About DIY Kitchen Remodel Costs
How much does a DIY kitchen remodel cost?
US costs vary widely with size, specification, and the amount of professional work retained. HomeGuide’s January 2026 benchmark estimates roughly $10,500–$42,500 for an average DIY kitchen renovation and about $50–$175 per square foot. Treat those figures as broad market benchmarks rather than a substitute for a project-specific DIY Kitchen Remodel Calculator estimate or local pricing.
Is it cheaper to remodel a kitchen yourself?
It can be. DIY reduces paid labor when the homeowner completes work correctly, but tools, rental equipment, waste, damaged materials, rework, and specialist assistance reduce the net saving. The strongest DIY opportunities are usually labor-heavy tasks where errors are inexpensive to repair.
How much money can DIY save on a kitchen remodel?
There is no guaranteed percentage. HomeGuide’s 2026 US benchmark estimates DIY kitchen renovations can cost roughly 15%–30% less than professionally completed remodeling, but actual savings depend on local labor rates, skill, tools, scope, and rework. Calculate your own net saving rather than applying the percentage automatically.
Can you remodel a kitchen for $10,000?
Some small or tightly controlled kitchen projects can stay near $10,000, particularly if the existing layout and some major components remain. A full replacement involving new cabinets, worktops, appliances, flooring, and extensive professional trades can exceed that figure quickly. Scope matters more than the budget label.
What parts of a kitchen remodel can I DIY?
Painting, hardware replacement, cleanup, some demolition, cabinet assembly, selected flooring, and backsplash work can suit capable DIYers. Cabinet fitting and finish carpentry require greater precision. Electrical, gas, structural, substantial plumbing, and expensive fabricated work deserve professional evaluation because the consequences of error are higher.
Which kitchen remodel jobs should I hire a professional for?
Consider professional help where mistakes could create fire, electrical, gas, structural, major water-damage, or expensive material risk. Local regulations also matter. New electrical circuits, gas work, structural changes, major plumbing relocation, and stone worktop fabrication are common examples where professional involvement may be appropriate.
How much contingency should I add to a DIY kitchen remodel?
Base contingency on uncertainty rather than using one percentage for every project. Cosmetic same-layout work in a newer home may need less protection than a renovation involving demolition, old services, layout changes, or concealed damage. Commercial UK renovation sources commonly use planning allowances around 10%–15%, but higher-risk projects may justify more.
Is it cheaper to keep the existing kitchen layout?
Often, yes. Retaining the sink, dishwasher, cooking zone, and major appliance positions can avoid changes to plumbing, electrical services, gas, ventilation, cabinets, flooring, and worktops. Moving one fixture may trigger several connected trades rather than one isolated expense.
Should I buy or rent tools for a kitchen remodel?
Buy tools that have reasonable future use and rent expensive specialty equipment you may need only once. Compare the full purchase price against rental and professional installation before assuming a tool investment will pay back during a single kitchen project.
How long does a DIY kitchen remodel take?
DIY generally takes longer because work is often completed around jobs, family commitments, and learning time. HomeGuide’s broader 2026 kitchen-remodel data places many professional remodels around six to nine weeks, while complex projects can take several months. A DIY schedule can extend further if tasks are limited to evenings or weekends.
Do I need a permit for a DIY kitchen remodel?
Possibly. Requirements depend on location and the work involved. Cosmetic updates may be treated differently from structural, electrical, plumbing, or service changes. US homeowners should check the applicable local building department. In England, Building Regulations and Approved Document P may be relevant depending on the work.
Can I install kitchen cabinets myself?
A capable DIYer can install cabinets, but successful installation requires more than assembling boxes. Floors may be out of level, walls may not be plumb, corners may not be square, and appliance or filler clearances must be maintained. The more expensive and complex the cabinetry, the higher the financial consequence of installation errors.
What DIY kitchen job do homeowners commonly regret doing themselves?
High-consequence tasks create the greatest potential regret: work involving expensive fabricated materials, difficult cabinet alignment, complex tile preparation, plumbing leaks, or regulated electrical and gas systems. A job does not need to be physically difficult to be financially risky.
What hidden costs appear after kitchen demolition?
Common surprises include damaged subfloor, moisture damage, poor previous repairs, uneven walls, obsolete wiring, plumbing problems, damaged plaster, additional waste, and missing preparation work. This is one reason contingency should remain untouched until concealed conditions have been inspected.
How much does a DIY kitchen renovation cost in the UK?
There is no reliable single national DIY figure because homeowners outsource different portions of the project. For context, Checkatrade’s 2026 kitchen data lists broad complete-kitchen and fitting costs, while BuildBank also shows substantial variation by specification, region, and layout. Use UK-specific pricing rather than converting US estimates directly into pounds.
Turn the Calculator Estimate Into a Budget You Can Actually Use
The strongest DIY Kitchen Remodel Calculator result is not necessarily the lowest number.
It is the estimate that survives contact with the real project.
Verify the scope first. Decide which tasks genuinely suit your ability. Obtain current prices for major materials and specialist trades. Check local requirements before regulated work begins. Protect contingency until concealed conditions are understood.
Then review the estimate again.
A well-planned partial-DIY remodel may deliver better financial value than attempting every task simply because labor appears expensive. The goal is not to prove that the whole kitchen can be built without professional help.
The goal is to spend your own time where it creates useful savings while protecting the budget from mistakes that cost more than the labor you hoped to avoid.
Ethan Caldwell (Expert — Residential Construction & Remodeling Cost Analysis)
Ethan Caldwell focuses on residential remodeling costs, renovation planning, project cost drivers, material decisions, contractor and trade considerations, and practical homeowner budgeting. His work emphasizes realistic cost planning, clear project assumptions, and the financial trade-offs homeowners face when deciding between DIY work and professional installation.
Also Read: DIY Kitchen Remodel Calculator
- Kitchen Remodel Cost Calculator — use when discussing a professionally managed or general remodel estimate.
- Kitchen Layout Change Calculator — use in the section covering sink, appliance, island, or utility relocation.
- Kitchen Lighting Cost Calculator — use where new lighting or electrical scope is discussed.
- Remodeling Kitchen Plumbing Cost Calculator — use when explaining sink and dishwasher relocation.
- Kitchen Remodel Timeline Calculator — use where DIY scheduling and project delays are discussed.
- Kitchen Remodel ROI Calculator — use only where project value or resale return becomes contextually relevant.
- Luxury Kitchen Calculator — use where premium materials and high-consequence installation risk are discussed.
A well-planned kitchen remodel is not about doing every task yourself—it is about knowing where your time, skill, and budget create the most value. Use your DIY Kitchen Remodel Calculator result as a working baseline, then refine it with real supplier prices, trade quotes, contingency, and the true cost of tools or rework. If you are still comparing project scopes, labor levels, or broader renovation costs, visit our Kitchen Remodeling resources for additional planning tools and cost guidance. A realistic DIY Kitchen Remodel Calculator estimate should help you make better decisions before materials are ordered and before expensive changes become difficult to reverse.
